Resource Optimization Strategy To Double Your Growth Rate

By
Ria Parish
28.5.2026
Resource Optimization Strategy To Double Your Growth Rate

New Projectworks data from over 700 firms points to one operational habit separating the fastest growers from the rest. (Spoiler alert: It's resource optimization.)

The question most consulting leaders ask about resourcing is whether they have enough pipeline to keep people busy. The question that actually drives growth is different: how far ahead are you resourced? The data shows that firms with strong forward resourcing practices don't just run better operationally. They grow faster, generate more revenue per person, and produce significantly stronger margins.

At Projectworks, we analyzed resource planning patterns aggregated across 700+ companies within our customer base, and found a consistent split between firms with forward visibility and those without.

The results were clear.

Firms that resource 50% or more of their staff at least eight weeks out show measurably stronger results across every metric tracked. Investing in resource management software gives you that visibility to make better resource planning decisions for your firm.

Here is what that utilization optimization looks like in practice:

+10% increase in billable utilization rate.
+10% increase in billable utilization rate.
At first glance, 68% versus 75% doesn't sound dramatic. But if you work through what that gap means for margin, the picture changes fast.

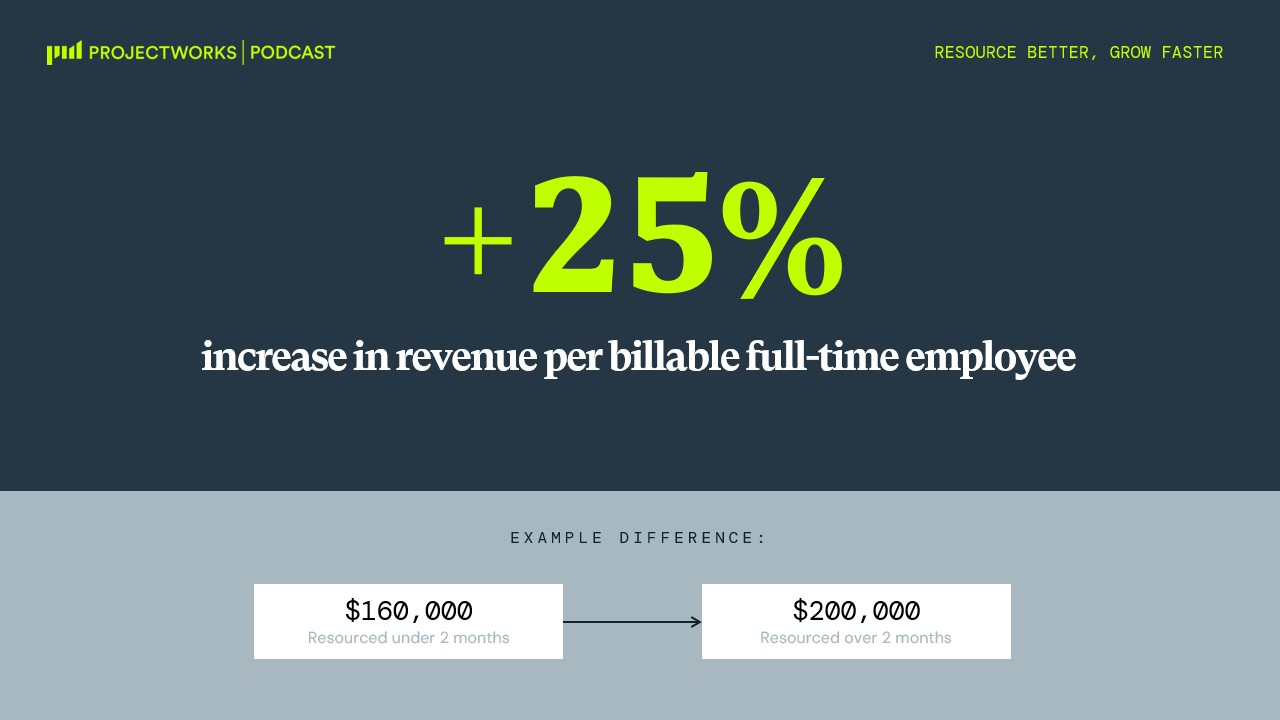

+25% increase in revenue per billable full-time employee.
+25% increase in revenue per billable full-time employee.
With the team you already have, resource optimization is a direct lever on revenue. No new hires required.

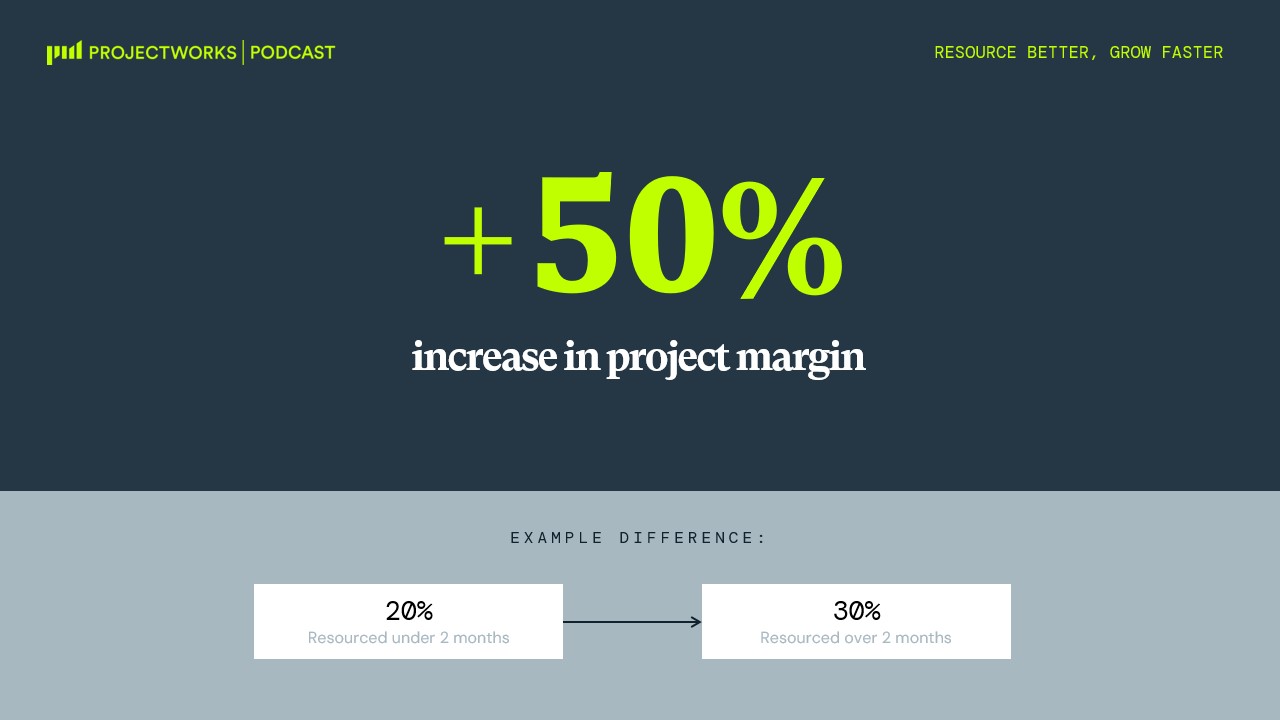

+50% increase in project margin.
+50% increase in project margin.
This one comes down to team composition. When you have real visibility over who is available and what they cost, you stop staffing from whoever happens to be free and start making decisions that protect the margin you quoted.
+100% increase in annual revenue growth rate.
+100% increase in annual revenue growth rate.
Firms with stronger resource planning practices grow at roughly twice the rate of those without. For anyone thinking about firm value, growth rate is one of the top two or three metrics a buyer looks at. Doubling it changes the conversation entirely.

At 75%, those results improved further still.

What resource optimization looks like in dollar terms

Percentages are useful, but dollars make it real.

So let’s take a look at what that same resource planning gap looks like across three firm sizes, holding all other assumptions constant: 10% sales and marketing costs, 10% admin costs.

Team Revenue Growth Margin Operating profit
20 staff
Under 2 months
$4m 15% 20% $0
20 staff
2+ months ahead
$5.2m 30% 30% $520,000
50 staff
Under 2 months
$10m 15% 20% $0
50 staff
2+ months ahead
$13m 30% 30% $1,300,000
100 staff
Under 2 months
$20m 15% 20% $0
100 staff
2+ months ahead
$26m 30% 30% $2,600,000
Assumes 10% S&M + 10% admin costs. Source: Projectworks data, 700+ firms.

The only variable across all three scenarios is how far ahead the firm is resourced.

Same team size.

Same cost structure.

The difference between breaking even and generating meaningful operating profit comes down to one operational habit.

Why utilization optimization is the metric that drives everything else

All the other metrics follow from one thing: closing the gaps between when one project ends and the next begins.

A week lost here, a free resource for two weeks there... In the moment, these feel like small concessions. Over a quarter, they add up fast. As Mark Orttung put it, "It's so easy in consulting: a week slips, or you give somebody a free resource for two weeks, and you don't really do the math on how much money you just gave away or how much your margin just dropped."

To put a number on what poor resource utilization is actually costing your firm, we can break down the full bench time cost formula here.

One resource optimization habit that makes an outsized difference is simply asking for renewals four to six weeks before a project ends, instead of in the final week. Getting to the last week and triggering a three-week renewal process means three weeks of bench time that was entirely avoidable.

Senior staff on the bench cost disproportionately more than junior staff. When capacity gets tight, the priority is getting your most senior people billable first. Two or three senior people sitting idle for a month is a material margin problem.

When things were challenging at Nexient, Mark Orttung shares, the team would sort the bench by seniority and cost, and work hard to get those senior people billable. Getting two or three of them back on projects would make a significant difference to margin for the week or the month.

"Closing all those gaps down raises utilization, and then all the other metrics go with it."
Mark Orttung, CEO, Projectworks

Who owns resource optimization and how to run it

At 20 to 50 staff, resource planning sits with whoever is running delivery. Give that person real-time project management reporting tools, and they can model scenarios and move allocations fast.

At 100-plus staff, you have enough operational weight to warrant dedicated back-office support for resource management, but the delivery lead still has to stay close to it either way.

The question of whether project managers should own resourcing comes up often. In smaller firms, the PM and the senior delivery owner are often the same person, and they absolutely need to be advocating for the right team on their projects. In larger firms, there is usually a more senior person who holds the firm-wide view and runs the central resourcing meeting.

The utilization metrics that should be front and center in every weekly resourcing meeting are:

  • Billable utilization rate
  • Revenue per billable employee
  • Project margin

Read our guide for consulting firms on how to calculate your utilization rate.

How long before resource optimization improvements show up in results

If you commit to the practice, resource optimization improvements can start to show within one to two quarters.

Start this week. Run a resource planning meeting with pipeline and capacity on the same screen. Ask for renewals four to six weeks before project end, not in the final week. Sort your bench by seniority and cost, and prioritize getting senior people billable first.

From there, the habits compound. Better resource visibility leads to better hiring decisions. Better team composition at the project stage leads to better margin. Better margin gives you room to run a healthier billable utilization rate and invest in developing your people.

"There is so much opportunity being left in how you operate projects. You celebrate winning the half-million-dollar project. There should be the same amount of focus and effort into operating it as efficiently as possible."
Dominique Rennell, CCO, Projectworks

The firms in this data that grow at twice the rate are not doing twice the selling. They are doing a better job of operating the work they already win. Forward resourcing is where that starts.

If you want to see what this looks like in practice, book a demo of Projectworks or start a free trial and run your first resourcing meeting with full pipeline visibility.

Join our professional services community

Subscribe for the latest updates delivered straight to your inbox.

By subscribing you agree with our Privacy Policy.
Enjoying this article?
Share it with the world!

Related Articles

Resource Optimization Strategy To Double Your Growth Rate
Resource Management
Z Suite
,
Growth

Resource Optimization Strategy To Double Your Growth Rate

New Projectworks data from over 700 firms points to one operational habit separating the fastest growers from the rest. (Spoiler alert: It's resource optimization.)

Your Best Proposal Content? It's Hiding
Proposals
Winning Work

Your Best Proposal Content? It's Hiding

Most professional services firms have more good content than they realise. The problem isn't that it doesn't exist, it’s that it lives in different, unconnected places and no one has full visibility over it. When a new RFP lands, you feel the pain immediately. Someone opens the last similar proposal and starts copying from it. Someone else messages a colleague for the right case study. By the time the first draft is circulating, the team has spent their most focused hours on logistics that should have been solved before the bid started.

Guide To Understanding Valuation Multiples
Consulting Advice
Professional Services 101
,
Growth

Guide To Understanding Valuation Multiples

Learn how EBITDA multiples work for consulting firms, what the realistic benchmarks are, and the six factors that move your multiple up or down.
